News - Archives
Last week 7th November 2004
- The unusually good weather allowed the south side of
the tender to be given it's first coat of black paint.
Click here for photos
Week ending 31st October 2004
- The remainder of the dome-headed rivets were put
into the tender base, leaving only a few countersunk rivets to complete the
job.
- The tender springs have been taken away for
refurbishing, we should get them back by Christmas.
Click here for photos of rivetting activities over the past
two weekends
Week ending 24th October 2004
- The driving rain on Sunday meant we couldn't
continue painting the tender, so we started putting in the 1/2" rivets
in the base of the tender tank. This was the first time we have used the new
forge and the hold-up tool was modified to sit on a stable base so that the
rivets could be heated up and inserted from underneath and riveted from
inside with the pneumatic gun. We went through a bit of a learning curve
initially, but managed to complete 41 rivets, about half the total. Photos
will be posted on the website for next week.
- Topcoated the remainder of the tender brake gear, so
we can free up workshop space in preparation for machining work over the
winter.
Week ending 17th October 2004
- Whilst Ian and I were away on half-term holidays
last week, Iain topcoated the tender drag-box and rubbed down the primer on
the tender cab interior.
- More rubbing down, filling and priming of the tender
tank.
- Packing up of the tender springs ready for
transportation down to England for refurbishing. Thanks to Sandy Mair for
his help with this.
- Tidying up of the scrap pile and setting up of the
press ready to start pressing out worn bushes from the spring links and
brake gear.
Coniston Water last week - click here for latest photos
Week ending 4th October 2004
- No update last week - offshore trips sometimes
interfere with engine restoration activities. This week and last were taken
up with more rubbing down and priming.
Click here for latest photos
Week ending 19th September 2004
- Today we were mostly rubbing down the paintwork with
wet and dry paper, between coats of primer. A thankless and boring task, so
our heartfelt thanks are due to Davie Murray and David Fraser who turned up
to help.
- Thanks also to Gordon Petrie, who arranged the
re-manufacture of 24 of the spring hanger pins for us.

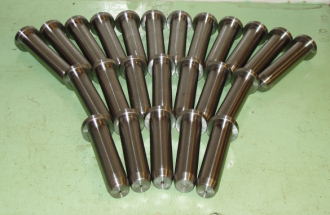

Pins requiring only cross-drilling to complete
Last week 12th September 2004
- Completed needle-gunning of tender cab.
- Wire mopped tender cab and applied primer.
- Completed welding the protective plates in place on the RHS
tender cab, and started on the LHS.

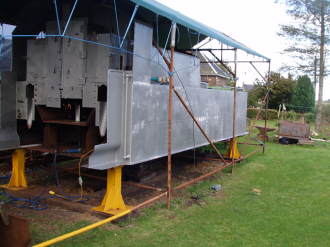

Tender cab primed and rubbing down in progress
Week ending 5th September 2004
- Completed needle-gunning of LHS of tender tank,
thanks to mid-week efforts by John, Ian and Robin.
- Wire mopped LHS of tender tank and applied primer.

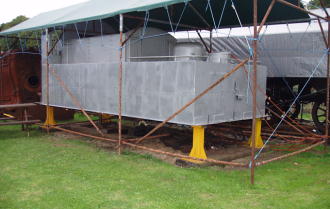

The newly primed tender tank.
Last week 29th August 2004
- Started needle-gunning LHS of tender tank.
- Welded up the remainder of the baffle repair
sections. All welding inside the tank is now complete, apart from putting
the end back on.
- Welded the protective plates in place on the RHS
tender cab. These are sacrificial plates to absorb the wear and tear from
the coal hitting the back of the cab.
- Cleaned out the rear compartment of the bothy, and
made up some storage shelving. This doesn't sound very exciting but if you
don't keep up with housekeeping activities you soon grind to a halt.
A rare shot of the bothy floor
Week ending 22nd August 2004
- Continued rubbing down operations on tender tank,
and applied second coat of primer to the back and RHS.
- Prepped and welded up three of the baffle repair
sections. See the Progress
section for photos.
Week ending 15th August 2004
Work
carried out during the last fortnight included
- Continued rubbing down operations on tender tank.
- Needle-gunned inside RHS tender cab and applied
first coat of primer.
- Burnt out of the last remaining of the cracked and corroded sections
of tender tank baffles.
- Cut out 6 No. baffle repair sections and prepped 3
of them ready for welding in.
- Cut out and prepped 4 No. reinforcing plates for the
tender cab where the coal hits it.
- Caught up on cutting the grass and tidied up the
site.
Week ending 1st August 2004
Summer holidays are upon us, hence the delay in updating the website. Work
carried out during the last 3 weeks included
- Second coat of primer applied to tender tank RHS and
end.
- Application of filler to rough areas of tender tank
and start of rubbing down operations.
- Partial dismantling of locomotive cab roof, freed
off hatch, and started welding in repair strips to replace corroded
sections.
- Burning out of all but one of the remainder of the cracked and corroded sections
of tender tank baffles.

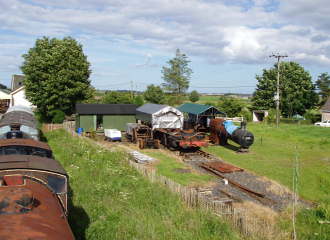

Overview of site showing renovated bothy
Week ending 4th July 2004
- Filed up penetrations in tender drag box wing
plates.
- Applied second coat of primer to tender drag box.
- Set up water butt for bothy.
- Burnt out half of the cracked and corroded sections
of tender tank baffles ready to weld in replacements.
Week ending 27th June 2004
- Completed renovation works on the bothy.
click here for
bothy update
- More needle-gunning and priming of the tender.
Week ending 20th June 2004
- Started fitting barge boards, soffits and guttering.
- Needle-gunning and priming of the tender in
progress.
Week ending 13th June 2004
- Finished the roof structure and now half way through
putting the corrugated roofing felt on.
Week ending 6th June 2004
- Finished cladding the bothy sides and completed a
third of the roof structure.
- Needle-gunned and wire mopped the tender tank water
scoop dome and applied primer. Applied second coat of primer to tender cab
rear. See photos in Progress page.
Week ending 30th May 2004
- Continued work to clad the bothy. This will be the
main focus of our activities for the next couple of weeks until it is
finished.
Week ending 23rd May 2004
- Needle-gunned the RH bunker side and the tender
manway cover and surround.
- Wire mopped both bunker sides, manway cover and
surround and tender cab rear, and applied first coat of primer.
- Started on cladding the bothy. The bothy was
originally a van body, and the walls are getting 'soft' at the edges. We are
framing the outside with 3" x 2" CLS, putting on a pitched roof, then cladding
it.
- Completed the forge and tested it successfully on
one burner. It should be ready to use in anger next week.
- Welded up the steam brake bell crank bracket and carried out
some minor modifications to the tender drag box to accept the vacuum brake
and steam heat piping.
Week ending 16th May 2004
- Finished the last of the rivetting on the RHS
d-strip. All the rivetting on the bunker is now complete.
- Ground up countersunk rivet heads on both d-strips
in readiness for painting.
- Started construction of a portable gas forge to heat
larger objects more effectively.
- More grass cutting. One of the joys of a rural
location with good soil and a mild microclimate.
Week ending 9th May 2004
- By way of a change, on Saturday some of us visited 'Steam in the Park', the Scottish Traction
Engine Society's event at Kinross.
click here for photos
- Finished putting in all the 1/2" rivets in the
bunker sides, about 40 in all.
- Refined the pneumatic hold-up tool and heating oven
to improve durability and speed of rivetting.
Week ending 2nd May 2004
- Rivetted the LHS d-strip in place, and some of the
rivets on the RHS d-strip. Started replacing 1/2" rivets on the LHS
bunker side.
- Successfully trialled the Hopley pneumatic hold-up
tool and the prototype rivet heating oven.
- Mowed the grass around the site.
Week ending 25th April 2004
- Continued bolting up joints with a final total of 48
nuts and bolts, about half of the total number of rivets requiring
replacement.
- Welded in three out of four baffle/ supports under
bunker floor. The fourth remains out to give better access for riveting. The
tank is now ready for a big riveting session.
- Some 'gardening' operations were conducted around
the site as the spell of warm weather has encouraged a spurt of growth.
Week ending 18th April 2004
- Hammered and raked out all scale from separated
rivet joints in tank.
- Started bolting up joints prior to re-riveting
Week ending 11th April 2004
- Needle-gunned handrail and padeye at rear of tender
tank in preparation for priming.
- Bolted up d-strip along bunker sides in preparation
for rivetting in place..
- Continued levelling ground for laydown area.
Last week 4th April 2004
- Prepared and primed rear of coal bunker.
- Drilled out retaining pins from remainder of tender
springs.
- Continued levelling ground for laydown area.
Week ending 28th March 2004
- Ground up replacement tank front ready for welding
in place.
- Preparatory work for weatherproofing workshop
started. The workshop is an old van body and is showing its age.
- Continued levelling ground for laydown area.
Week ending 21st March 2004
- Completed wooden pattern for new tank front.
- Dismantled rear trailing tender spring for
refurbishment and replacement of broken leaves.
- Continued preparation inside tank for rivetting and
welding.
- Installed forced ventilation fan to tank for
painting.
- Cut new steel to shape for new tank front.
Week ending 14th March 2004
- Made up pneumatic holding up tool for 1/2"
tender tank rivets.
- Completed preparation of tank front for replacement
steel section.
- Part completed wooden pattern for shaping new steel.
- Continued preparing ground for laydown area.
Week ending 7th March 2004
- Completed tank rivet removal and started removing
trapped scale prior to bolting back sections for re-riveting.
- Removed mounting pads from front of tank to allow
trimming up of steel for new tank front.
- Removed rear sand boxes from engine.
- Prepped and tack welded steam brake bell-crank
bracket on engine ready for refixing. This bracket had to be cut off in an
emergency whilst the loco was being moved by road transporter from Aviemore.
- Straightened out several bent handrails around
tender tank.
Week ending 29th February 2004
- Took advantage of the fine day to refine the tender tank tent
arrangement.
- Installed 110v festoon lighting inside tender tank.
- Removed defective rivets from front third of tender
tank floor.
- Made a start on preparing the plating at the front
of the tender tank to accept the new repair section.
Week ending 22nd February 2004
- Fitted tarpaulin cover to tender tank tent despite
high winds and snow.
Week ending 15th February 2004
- Welded up the rivets on the RHS of the tender tank
which had been ground flush to give a flat surface for the 'Cycling Ferret'
transfer and which had subsequently started to leak.
back
